Add and edit an activity in the phase plan
Build and adjust your phase pull plan
In the phase pull, you can add, edit and manage high-level planning activities directly. You can create new tasks, adjust details and manage constraints — all within the planning view.
Add a new activity
To add an activity to a phase pull lane:
- Right-click on the lane in which you want to place the activity (or press and hold on a touchscreen).
 - In the contextual menu, select Add activity.

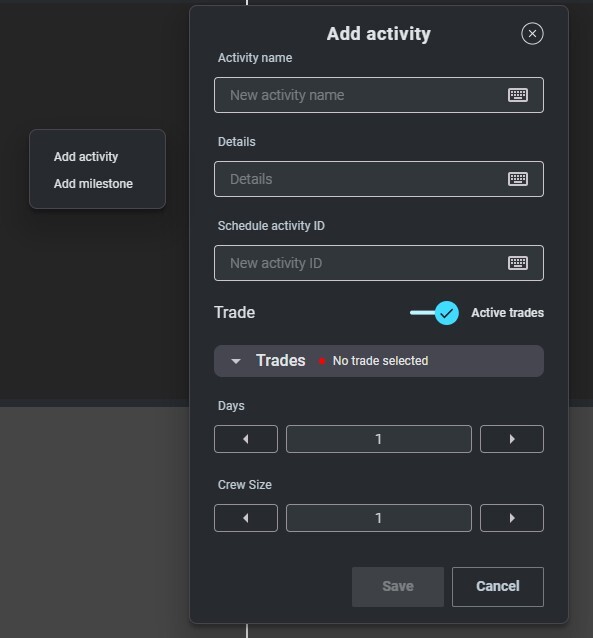

 - The Add activity dialog will open. Fill out the following fields:
- Activity name — required.
 - Schedule activity ID — optional.
 - Trade — required. Select from the drop-down list.
- By default, only active trades are shown.
 - Use the Active trades toggle to view all trades (active and inactive).

 - Number of days — duration of the activity (1–99). Default is 1.
 - Crew size — number of people assigned (1–99). Default is 2.

 - Click Save to create the activity or Cancel to discard changes.

Note: The Save button will remain disabled until all required fields are completed.

Edit an existing activity
To modify an activity already placed in the phase pull lane:
- Right-click any tag of the activity you want to update.
- Alternatively, double-click (or double-tap on a touchscreen) to open the edit dialog.

 - In the menu, select Edit activity.
 - The Edit activity dialog will open. You can update:
- Activity name — required
 - Schedule activity ID — optional
 - Trade — required (select from drop-down list)
 - Constraints — view any existing constraints tied to the activity
- Use the drop-down list to review constraints
 - Click Add constraint to open the constraint creation dialog

 - Copy activity — use this option to create a duplicate activity with the same setup

 - Click Save to confirm your edits or Cancel to discard.

Note: To adjust the number of days in an activity, use the 3-dot control in the lower-left corner of the tag.
Add a constraint to an existing activity
Inside the Edit activity dialog, you can add a constraint to the selected activity. Adding constraints directly in the dialog ensures that blockers are captured in real time and associated with an activity — keeping the whole team informed and proactive.
- On the constraint drop-down list, click Add constraint.
 - Fill out the following fields:
- Constraint name — required
 - Activity constrained — auto-filled
 - Details optional — add relevant notes
 - Person responsible — optional
 - Date to be resolved — optional (choose from the calendar)

 - Click Save to create the activity or Cancel to discard changes.

Note: The Save button will remain disabled until all required fields are completed.
Note: When a constraint is added to a task, a yellow dot will appear on the affected tag — and on all dependent tags from the same activity. This visual cue indicates that the activity is under a constraint that will require resolution before proceeding or moving the tag to the weekly commitment plan.
Edit a constraint in the edit activity dialog
After constraints have been created, they appear in a list in the Edit activity dialog. To edit a constraint:
- Right-click the tag to open the Edit activity dialog.
 - Click the constraint in the list to open the Edit constraint dialog.
 - In the dialog, you can update:
- Constraint name — required
 - Activity constrained — auto-filled
 - Details — optional notes or context
 - Person responsible — optional
 - Date to be resolved — choose a deadline in the calendar
 - Resolved toggle — when enabled, a new field appears for entering the Resolved date

 - Click Save to confirm your changes or Cancel to discard them.

Note: When the Resolved toggle is turned on and a Resolved date is set and saved:
- The constraint will be marked as resolved in the constraint log.
 - It will be removed from the list of any activities it previously affected.
 - The yellow-dot indicators on those activity tags will also disappear, showing that the constraint is no longer active.
