Import master milestones
Set up high-level deadlines by importing milestone data
With master milestones, you can establish project-wide checkpoints that will appear consistently in both the weekly view and phase pull view. These milestones in Nialli™ Visual Planner come from the master schedule that is typically in Microsoft® Project, Oracle® P6 Professional or Asta Powerproject®, and they serve as fixed reference points for planning and performance tracking.
Prepare the milestone import file
- Export milestone data to Excel® or CSV format from Oracle P6, Asta Powerproject, Microsoft Project or a similar platform.
 - Your file must include the following fields only:
- ID — ID of the milestone.
 - Master milestone name — name of the milestone.
 - Date — YYYY-MM-DD.

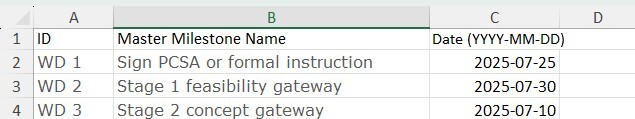

 - Remove any additional columns — only keep columns A to C. Arrange them as:
- Column A — ID.
 - Column B — Master milestone name.
 - Column C — Date (YYYY-MM-DD).



Format dates to YYYY-MM-DD
If your file already uses the YYYY-MM-DD format, skip this section. Otherwise:
- Select the entire Date column.
 - Right-click the column header and select Format.
 - In the Number formatting dialog:
- Select Locale: English (United States).
 - Set the format to YYYY-MM-DD.


All dates should now display correctly.
Save the file on your computer in a location that you will browse to when importing the milestones in the next step.
Import master milestones
- Open Nialli Visual Planner and click the Nialli logo to open the side menu.
 - Select Settings, then go to the Plan tab.
 - Select Import master milestones.
 - Click Browse to select the Excel file you prepared.
 - Click OK to confirm.

Upon import:
- A dedicated master milestones lane will appear in weekly view and phase pull view.
 - Milestones can be added again as needed.
 - The lane is fixed (1/3 size) and cannot be collapsed.
 - Important note: The master milestones lane cannot be deleted.

Using master milestones in your plan
To create a plan milestone from a master milestone:
- Click and hold the master milestone.
 - Drag it into the required lane.
 - Release it to drop a copy, which you can then edit.

If multiple milestones fall on the same day, they stack. Click the stack to cycle through them.
Selecting a master milestone will highlight all associated plan milestones.
Deviation warning: If a plan milestone is moved away from its master milestone, an alert will appear showing how many days it has shifted forward or back
